Technical Knowledge
How to achieve ultra-high floor flatness standards of FF ≥ 50 through equipment collaboration?

Achieving ultra-high standards of FF ≥ 50 (flatness) and FL ≥ 35 (levelness) has elevated floor construction to a "surgical" level of precision. This is no longer about the performance of a single piece of equipment, but rather a deep collaboration of three elements: **"laser initial leveling + manual precision trimming + ride-on power trowel fine compaction."**
The following is a practical equipment collaboration plan for achieving FF ≥ 50:
I. Core Equipment Link and Key Parameters
To achieve FF ≥ 50, the error propagation between equipment must be controlled at the millimeter level.
1. Laser Leveling Machine: Transitioning from "Automation" to "Semi-automatic Fine-tuning"
Equipment Selection: A large telescopic arm laser leveling machine must be used, as its leveling head stability is far superior to smaller machines.
Coordination Techniques: The laser sensor frequency should be set to the highest level. During the leveling process, the operator needs to reduce the travel speed by 30%, giving the hydraulic system more ample response time to correct the elevation.

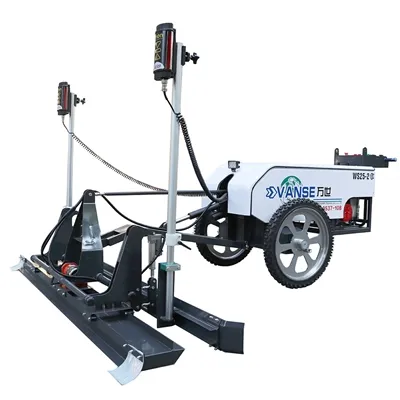

2. Wide-width Aluminum-Magnesium Alloy Straightedge (Highway Straightedge): A Critical Link
Role: This is the decisive factor in crossing the threshold from FF30 to FF50.
Coordination Techniques: After laser leveling and before the initial setting of the concrete, two experienced technicians use 3m – 4.5m long-handled straightedges to perform a crisscross, back-and-forth leveling in a grid pattern.
Accuracy Correction: The straightedge must be perpendicular to the direction of travel of the laser leveling machine, aiming to eliminate the subtle waviness generated by the laser head during gear changes or overlapping paving.
II. The "Torque Control" Strategy for Power Trowel Teams
In projects where FF ≥ 50, power trowels are used not only for polishing but also to eliminate small bumps through compaction.
1. Slurry Application Stage (Disc Operation)
Equipment: Heavy-duty ride-on power trowel.
Coordination: Real-time monitoring with an infrared level is essential. If any localized elevation deviations are detected, use the power trowel's disc to "push and fill" the slurry to correct the level.
2. Fine Leveling Stage (Blade Operation)
Angle Control: The tilt angle of the trowel blades must be strictly consistent.
Overlapping Coverage: Use the "1/2 overlap method," meaning the path of the second pass must overlap half of the first pass to ensure there are no unpolished areas or steps.
III. Real-Time Monitoring Equipment: Dipstick Real-Time Intervention
In ultra-high standard construction, testing cannot wait until the next day; it must be a process of **"construction, testing, and correction simultaneously."**
Equipment: Dipstick automatic flatness tester (or similar F-Number testing instrument).
Collaborative Process:
Immediately after the first pass of fine leveling and finishing, the technician conducts spot checks on the floor.
If a downward trend in the FF value is detected, the finishing machine operator is immediately instructed via radio to repeatedly compact the high spots or add small amounts of material to the low areas.
Thermal Correction: Corrections are completed while the concrete is still plastic; this is the last opportunity to achieve FF50.
IV. Collaborative Workflow Checklist
| Stages | Equipment coordinated operation | Accuracy Objectives |
| Spreading | Laser Leveling for uniform spreading + manual assistance for filling material at the edges of the formwork | Error: ±3 mm |
| Initial leveling | Long-handled Leveling (horizontal + vertical) reciprocating motion for more than 3 passes | Eliminate mechanical undulations |
| Grouting | Ride-on power trowel (with disc attachment) for overlapping compaction | Ensure uniform density |
| Fine leveling | Final manual leveling using a 3-meter Leveling | Eliminate grout ridges left by the disc |
| Final finishing | High-speed trowel blades for finishing + real-time monitoring and feedback | Achieve FF ≥ 50 |
V. Passive Coordination of Environment and Materials
Even the best equipment cannot achieve the desired results if the materials are not compatible:
Slump coordination: The slump variation of each batch of concrete must be controlled within ±10 mm.
Temperature control coordination: Indoor wind speed should be controlled below 2 m/s to prevent rapid water loss from the surface, which can lead to drying shrinkage and damage the achieved flatness.
Note: The parameters provided in this document are for reference only and are not mandatory. Due to differences in technical characteristics between different brands and models of laser levelers, please consult the manufacturer for a suitable solution before actual operation. This reference document assumes no responsibility for any issues arising from failure to follow the manufacturer's instructions.
